IB Syllabus Requirements for Crisis management and contingency planning
5.7.1
The difference between crisis management and contingency planning
5.7.2
The factors that affect effective crisis management
5.7.3
The impact of contingency planning for a given organization or situation
5.7.1
THE DIFFERENCE BETWEEN CRISIS MANAGEMENT AND CONTINGENCY PLANNING
Crisis management is the process a business uses to respond to an unexpected, serious event while it is happening or after it has happened. By this stage, the organization is already under pressure. Operations may be disrupted, stakeholders may feel frightened or angry, and managers must make quick decisions without having perfect information.
Contingency planning happens before a crisis. The business identifies possible future disruptions, then decides in advance what actions to take, who will be responsible and which resources they will need. This isn’t fortune-telling. It’s structured “what if?” thinking: what if the supplier fails, the factory floods, the payment system goes down, a product is unsafe, or a senior leader suddenly leaves?

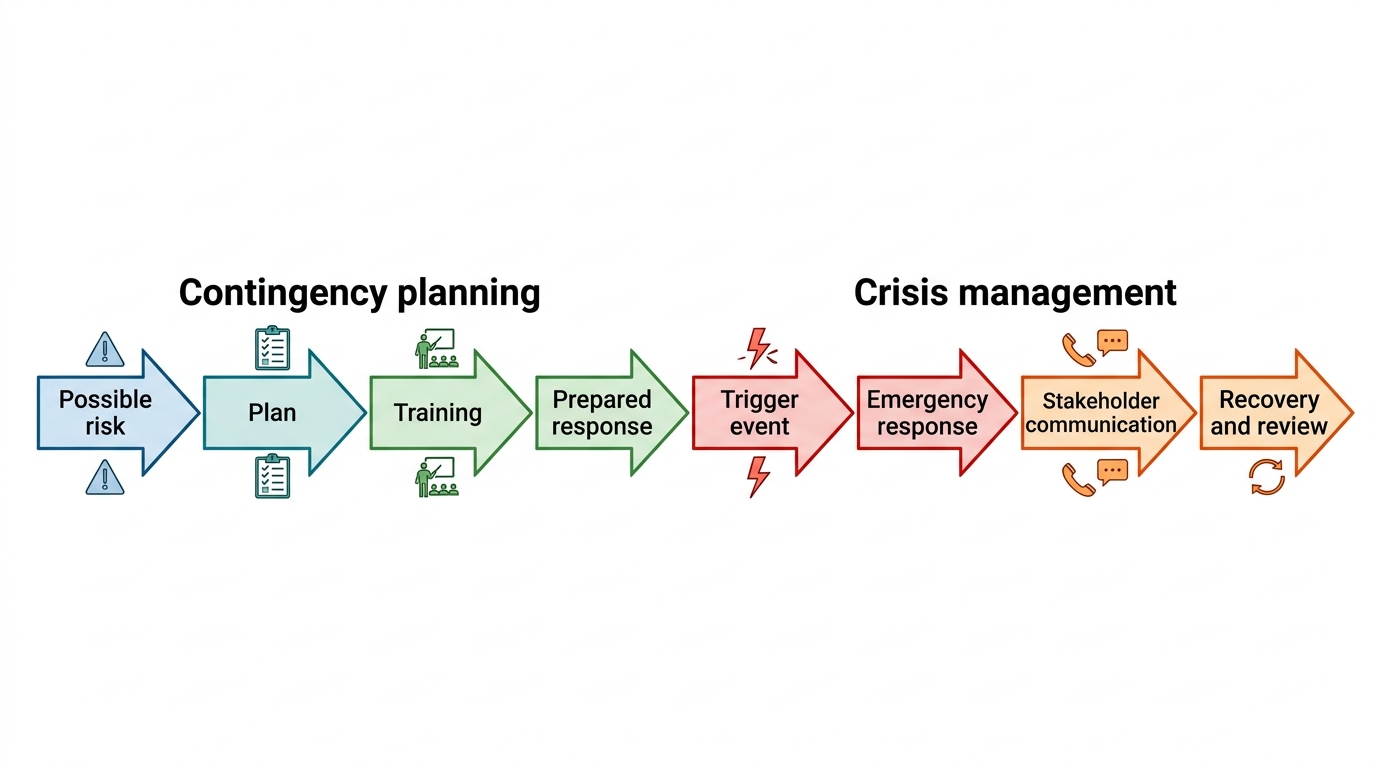

The distinction is straightforward: crisis management is mainly reactive, whereas contingency planning is mainly proactive. The two still connect in practice. A strong contingency plan helps the business manage a crisis more calmly, quickly and with better coordination. Without proper preparation, an organization has to invent its response in public—usually when emotions are running high and the media is already paying attention.
Operations management focuses on producing goods and services reliably. A crisis puts that reliability at risk. Production may stop, deliveries can be delayed, quality may fall, employees or customers could be endangered, and the organization’s reputation may suffer. This goes beyond public relations. The aim is to keep the organization working when its normal routines break down.
A crisis is a serious event that threatens an organization’s operations, finances, reputation or stakeholder safety and requires urgent decision-making. External crises include extreme weather, political unrest and sudden supply chain disruption. Internal crises can arise from equipment failure, data loss, workplace accidents or poor-quality output reaching customers.
A stakeholder is a person, group or organization that is affected by, or can affect, a business decision. During a crisis, this may include employees, customers, suppliers, local communities, regulators, owners, lenders and the media. One event can affect each group in a different way, so priorities and communication matter greatly.
| Aspect | Crisis management | Contingency planning |
|---|---|---|
| Main timing | During or immediately after the event | Before a possible event |
| Main purpose | Limit damage and restore control | Reduce the chance and impact of disruption |
| Nature of decisions | Urgent, often made under uncertainty | Planned, tested and reviewed in advance |
| Typical activities | Public statements, emergency actions, operational fixes, stakeholder updates | Risk assessment, staff training, backup suppliers, evacuation procedures, reserve resources |
| Main weakness if done badly | Confusion, delay, loss of trust | Wasted resources, outdated plans, false sense of security |
Leadership fits naturally into this topic. Before a crisis, senior managers set priorities; during one, they must take visible responsibility. Communication has a major role as well. Internal communication keeps employees coordinated, while external communication keeps customers, suppliers and other stakeholders informed. Budgets also matter because contingency plans often need reserve funds, backup capacity or insurance.
5.7.2
THE FACTORS THAT AFFECT EFFECTIVE CRISIS MANAGEMENT

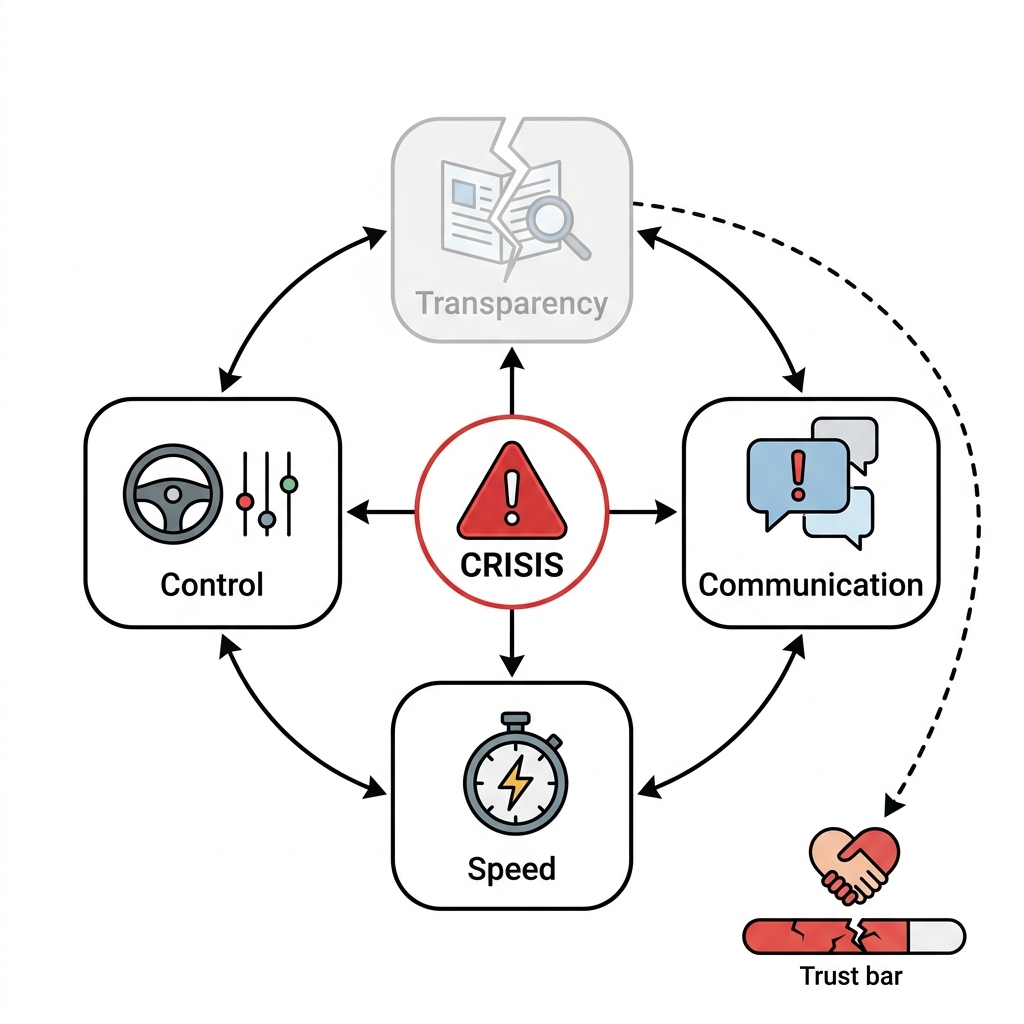

When a crisis occurs, stakeholders watch what the organization does and how it communicates. Four factors sit at the centre of effective crisis management: transparency, communication, speed and control. They overlap, but do not treat them as the same word in four different outfits. Each one asks a different question.

Transparency is the practice of providing accurate, honest and relevant information to stakeholders rather than hiding, distorting or delaying important facts. In a crisis, transparency builds trust because people can see that the organization is not trying to protect itself at everyone else’s expense.
Transparency does not mean releasing every detail immediately. Some facts may be unknown, commercially sensitive or legally restricted. Good transparency means saying what is known, what is not yet known, what is being investigated and when the next update will come. That is much better than pretending to know everything.
Ethics belongs here. Stakeholders expect truthful communication, especially when safety, livelihoods or public confidence are at stake. A business that conceals information may reduce embarrassment in the short term, but it often increases reputational and legal damage later.
Communication is the process of exchanging information between a sender and a receiver so that meaning is understood. In crisis management, communication must work both internally and externally. Internally, employees need clear instructions: who is doing what, which procedures apply, and what they should tell customers. Externally, stakeholders need timely updates that are consistent and understandable.
Senior managers matter because they set the tone. If different departments give different messages, the organization looks disorganized. If frontline employees hear news from social media before hearing from managers, morale and confidence fall. A sensible crisis communication system usually has named spokespeople, approved channels, short update cycles and a record of what has been communicated.
The best crisis communication is two-way. Customers may report product faults, employees may identify operational risks, suppliers may explain delays, and regulators may require specific information. Listening is not a soft extra; it improves the quality of the response.
Speed is the rate at which an organization takes decisions, acts and communicates during a crisis. In this topic, speed is not the same as panic. Fast action is valuable when it prevents harm, reduces uncertainty or stops the crisis spreading. Slow action can make even a manageable problem look like negligence.
There is a balance. Acting too quickly without checking facts may create mistakes, false promises or unsafe decisions. The practical aim is rapid, informed action: acknowledge the issue quickly, protect people first, investigate properly, and keep updating stakeholders as facts become clearer.
Speed is strongly linked to preparation. Organizations with trained teams, emergency procedures, backup systems and clear authority lines can move faster because they are not debating basic responsibilities during the crisis.
Control is the ability of managers to coordinate resources, decisions and information so that the effects of a crisis are contained and recovery becomes possible. Control does not mean controlling every outcome; crises are messy. It means reducing chaos.
Control may involve stopping production, recalling a product, switching suppliers, moving staff to safe locations, closing a site, activating cybersecurity procedures, or prioritizing key customers. It also means controlling rumours by giving reliable information and controlling operational damage by focusing on the most urgent risks first.
The concept of change fits neatly here. Some managers prefer optimism and risk-taking, especially in entrepreneurial cultures. That can be useful in normal growth periods, but crisis management requires the discipline to imagine unpleasant changes too. Good managers think about the best case and the worst case, then prepare for both.
A crisis response is weak if any one of the four is missing. Fast communication that is not transparent becomes spin. Transparent communication that is too slow may arrive after trust has already collapsed. Strong control without communication leaves stakeholders confused. Communication without control sounds busy but changes little.
For analysis, always connect the factor to the organization and situation. A hospital, a school, an airline, a manufacturer and an online retailer do not face the same stakeholder expectations or safety risks. The factor is the same; its importance changes with context.
5.7.3
THE IMPACT OF CONTINGENCY PLANNING FOR A GIVEN ORGANIZATION OR SITUATION
When analysing contingency planning, consider its effect on cost, time, risks and safety. The wording “for a given organization or situation” matters here. What makes sense for a chemical manufacturer could be excessive for a small clothing retailer. Similarly, a large multinational may easily afford a plan that would be impossible for a start-up.
Impact refers to the effect a decision or event has on an organization or its stakeholders. In contingency planning, that effect may be positive, such as faster recovery, or negative, such as increased short-term costs.
Cost is the financial sacrifice an organization makes to obtain a resource, carry out an activity or deal with a problem. Planning for contingencies can involve staff training, backup equipment, duplicate data systems, insurance, safety audits, reserve inventory, emergency drills and professional advice.
When there’s no crisis, these costs may seem unattractive. Some managers therefore underinvest in planning because its benefit stays hidden until something goes wrong. Yet failing to plan can cost far more. The organization might lose sales, face legal claims, pay compensation, suffer downtime or need to rebuild trust after responding poorly.
Opportunity cost also needs to be considered. Opportunity cost is the value of the next best alternative forgone when a decision is made. Money used for backup systems is no longer available for promotion, product development or staff bonuses. A strong answer weighs up this trade-off instead of simply claiming that “planning is good”.
Time is the period needed to prepare, implement, test and update a business activity. Before a crisis even occurs, contingency planning uses management time. Staff may require training. Procedures must be written, emergency contacts checked, and plans rehearsed.
During the crisis, however, the organization may gain that time back. Clear responsibilities allow managers to act faster. Purchasing teams won’t have to start from zero if alternative suppliers have already been assessed. Employees who have practised evacuation or system recovery are also less likely to make mistakes.
A plan can become outdated. If it still relies on last year’s suppliers, staff structure or technology, it may be dangerous unless someone updates it. The time commitment is therefore ongoing, rather than a one-off task that can be completed and forgotten.
Risk is the possibility that an event will occur and have negative consequences for an organization or its stakeholders. Contingency planning begins with identifying risks, estimating their likelihood and judging the seriousness of their possible consequences.
A risk assessment is a structured evaluation of possible hazards, their likelihood, potential impact and the action needed to reduce them. Organizations often record this information in a risk register, a document listing key risks, owners, likelihood, impact, preventive actions and response actions.
Risk assessment register for contingency planning
| Risk description | Affected stakeholders | Likelihood | Impact | Preventive action | Response action | Responsible person / team |
|---|---|---|---|---|---|---|
| Fire in premises | Employees, customers, nearby businesses | Low | Very high | Fire alarms, staff drills, clear exits, equipment checks | Evacuate, call emergency services, account for people, relocate if needed | Health and safety manager / site team |
| IT system outage | Staff, customers, suppliers | Medium | High | Regular backups, cybersecurity controls, system testing, UPS power | Switch to backup systems, use manual processes, restore data, notify users | IT manager / IT support |
| Key supplier failure | Production staff, customers, shareholders | Medium | High | Use more than one supplier, safety stock, supplier checks, contracts | Activate alternate supplier, adjust schedules, prioritise orders | Procurement team |
| Flood or severe weather | Employees, customers, local community | Low | High | Weather monitoring, flood barriers, remote-working plan, secure records | Close site, move critical equipment, shift to remote operations | Operations manager |
Planning can reduce risk, but it rarely removes it altogether. Backup suppliers, for instance, reduce dependence on a single supplier, though they may cost more or prove less reliable. Spare inventory lowers the risk of stockouts, but raises storage costs and creates a greater risk of obsolescence. Good analysis should focus on reducing and trading off risks, rather than eliminating them.
Safety is the condition in which people are protected from unacceptable harm. When preparing contingency plans, safety should usually take priority over cost and convenience. Those protected may include employees, customers, contractors, visitors and, in some cases, local communities.
Depending on the organization, safety planning could cover evacuation routes, protective equipment, product recall procedures, food hygiene controls, cybersecurity access rules, machine shutdown procedures or emergency medical arrangements. Priorities will differ: a theme park doesn’t face the same safety needs as a delivery company, data centre or food producer.
There is a clear ethical dimension. If a business knows that a serious danger could arise but fails to prepare, stakeholders are likely to judge it harshly. Legal consequences may follow. The ethical issue comes first, though: people shouldn’t face avoidable harm simply because planning was inconvenient.
An effective contingency plan is realistic, affordable, understood by staff and suited to the main risks. Too little planning leaves an organization exposed. Too much may produce bureaucracy, high costs and slower decision-making.
For a given situation, ask four questions:
The strongest judgement will usually depend on the circumstances. Contingency planning has the greatest value when a crisis could cause severe damage, safety is at stake, or operations rely on systems that cannot fail for long. Less extensive planning may be appropriate when risks are minor, resources are very limited, or the organization can recover quickly without major harm.
